Table of Contents

Technical Documentation: 4D Construction Dashboard

Executive Overview

The 4D Construction Dashboard serves as a specialized Digital Twin, integrating Building Information Modeling (IFC Data) with Construction Scheduling and Management. By linking the physical model (ifc) directly to the project schedule, it provides stakeholders with a "time-machine" view of the project's progress.

This tool is essential for Project Managers, Planners, and Site Engineers to validate schedules, track delays, and visualize the sequence of work before execution.

Input Data Requirements (Critical)

To ensure the dashboard functions correctly, the input data MUST follow a strict structure. The Power BI model relies on a specific Excel template linked via parameters.

1. Download the Template

Start by downloading the standard Excel template. Do not rename the sheets inside this workbook.

Download 4D Planning Template

2. Sheet: Task_Table (The Schedule Source)

This is the primary dataset driving the Gantt chart and 4D simulation.

Important: The sheet name must remain exactly Task_Table.

Attribute Name Data Type Description & Usage
ActivityID Text / Number Primary Key. A unique identifier for each task. This ID is often used to link with the BIM Model (e.g., matching the Mark or Tag parameter in Revit).
TaskName Text A descriptive name for the activity (e.g., "Pouring L2 Slab"). Appears in the Gantt Chart.
WBS Text Work Breakdown Structure. Used to group tasks hierarchically (e.g., "First Floor > Structure").
Status Text Crucial for Coloring. Valid values are: Completed, In Progress, Not Started. This field directly controls the 3D visualization colors.
PercentageComplete Decimal Represents progress (0.0 to 1.0). Used for earned value calculations.
PlannedStart Date The scheduled start date. Must be a valid Date format.
PlannedFinish Date The scheduled finish date. Must be a valid Date format.
ActualStart Date (Optional) Real-world start date for comparison logic.
ActualFinish Date (Optional) Real-world finish date.
OriginalDuration Number The planned duration in days.

Task Table Example

Figure 1: Example of a correctly populated Task_Table.

3. Sheet: ResourceToTask (Cost & Resources)

This sheet handles the "4D" aspect (Cost) by linking resources to specific activities.

Important: The sheet name must remain exactly ResourceToTask.

Attribute Name Data Type Description & Usage
ResourceGUID Text Unique ID for the resource (Labor, Material, Equipment).
ActivityID Text Foreign Key. This MUST match an ActivityID from the Task_Table. It links the cost to the schedule.
Cost Currency The financial value associated with this resource allocation.

Resource Table Example

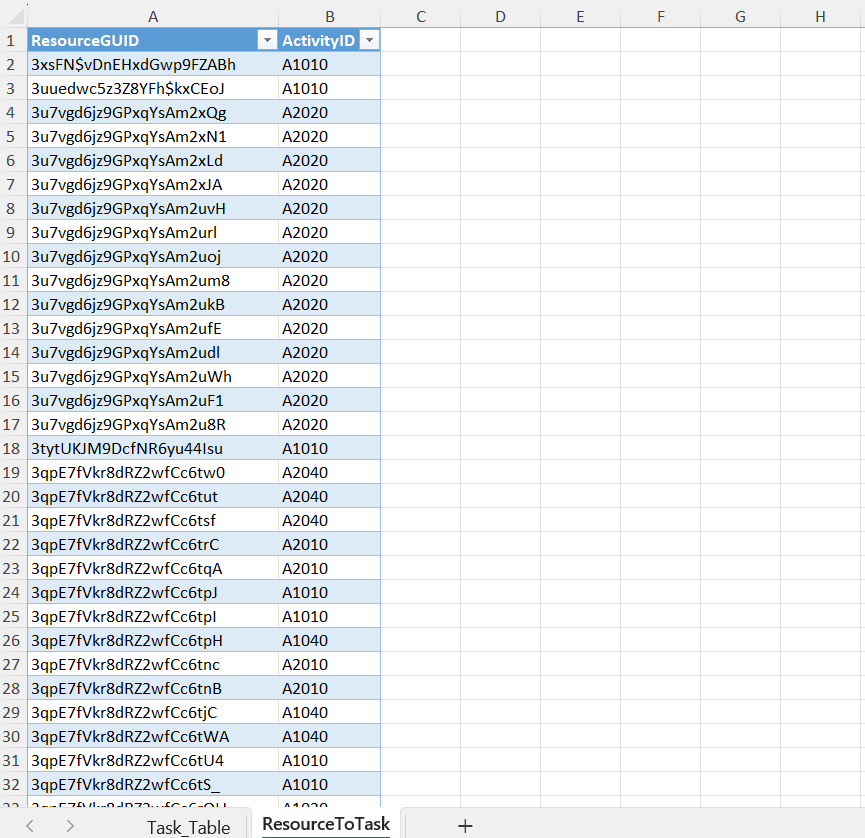

Figure 2: Linking Resources to Activities.

Setup & Configuration Guide

The dashboard is designed to be dynamic. You don't need to edit the Power BI file structure; simply update the connection parameter.

  1. Open the Power BI Report (.pbix).
  2. Go to Home > Transform Data > Edit Parameters.
  3. Locate the parameter named 4D_Planning_Template.
  4. Paste the full file path of your local Excel file.
    • Example: C:\Users\Name\Projects\4D_Schedule.xlsx
  5. Click OK and then Apply Changes.

How to Update Progress

As the project moves forward, you only need to update the Excel file:

  1. Open your linked Excel Workbook.
  2. Update the Status column (e.g., change specific tasks from "In Progress" to "Completed").
  3. Update PercentageComplete and Actual dates if necessary.
  4. Save the Excel file.
  5. In Power BI (or the Web Viewer), click the Refresh button. The Dashboard, Gantt Chart, and 3D Coloring will update instantly.

Technical Logic: Status & Coloring

The dashboard utilizes a DAX Logic Matrix to assign statuses dynamically based on the comparison between the Timeline Date (selected by the user) and the Task Dates.

Visual Status Color Code Logic Condition
Completed Green Work that has been fully finished historically (Task Finish Date < Selected Date).
In Progress Yellow Work currently active on site (Selected Date is between Start and Finish).
Not Started Red / Transparent Future scope. Often rendered with high transparency to focus on active work.
Delayed Orange Tasks where Planned Finish < Today but % Complete < 100%.
